02 — Datum Plane
The Electrical Datum Plane: Measured From the Tide
The National Electrical Code, adopted in Virginia in its 2020 edition, uses a reference called the electrical datum plane. Equipment can be installed, and connections made above it, and Section 555.3 sets its height.
Fixed piers and land on tidal water
Where land is subject to tidal fluctuation, the line sits 2 feet above the highest high tide your pier normally sees. That covers most fixed piers on Norfolk’s creeks. For water that does not rise and fall with the tide, the code uses 2 feet above the highest normal water level.
Floating docks
A floating dock that rises and falls with the water carries its datum plane with it. For those, the plane sits 30 inches above the water level at the float and at least 12 inches above the deck. The code applies to that moving plane, which is built to rise and fall with the water without lateral movement, and to rise as high as the fixed datum plane.
Where connections can be made
Once the plane is set, the dock rules decide where each connection and enclosure may sit. The table below sums up the 2020 limits we plan around.
In practice, the same receptacle post can be correct on one pier and too low on the pier next door, because the decks sit at different heights above the tide. The code’s reference point is the highest high tide under normal conditions, not the deck height.
03 — Under the Pier
Wiring Methods Under and Along the Pier
The NEC’s dock wiring rules allow standard wiring methods on a pier when they are identified for wet locations and carry a wire-type insulated equipment grounding conductor.
The code also allows extra-hard-usage portable power cable, listed for wet locations and sunlight resistance, as permanent wiring under the pier and where flexibility is needed across floating sections, properly supported.
On many Norfolk properties, a fixed pier crosses the marsh, and a floating dock sits at the end on a gangway. That moving transition is where the wiring method matters most.
04 — Feed From Land
Feeding the Dock From Shore
Under Section 555.4 of the 2020 NEC, the service equipment for a dock is located on land adjacent to the structure it serves. It cannot be mounted on or in the dock itself or on any other floating structure.
For most homes, power reaches the pier through feeder or branch circuits from the house panel. Where the dock gets its own disconnect on land, we usually place it near the head of the pier, above the datum plane, so we plan the route and the equipment location together.
Lift motors, lights, and boathouse circuits add up, so we check panel capacity at the estimate. Waterfront yards often have a pool or hot tub as well, and our pool and hot tub wiring in Norfolk is planned from the same panel review.
05 — Boathouses
Boathouses and Covered Lifts

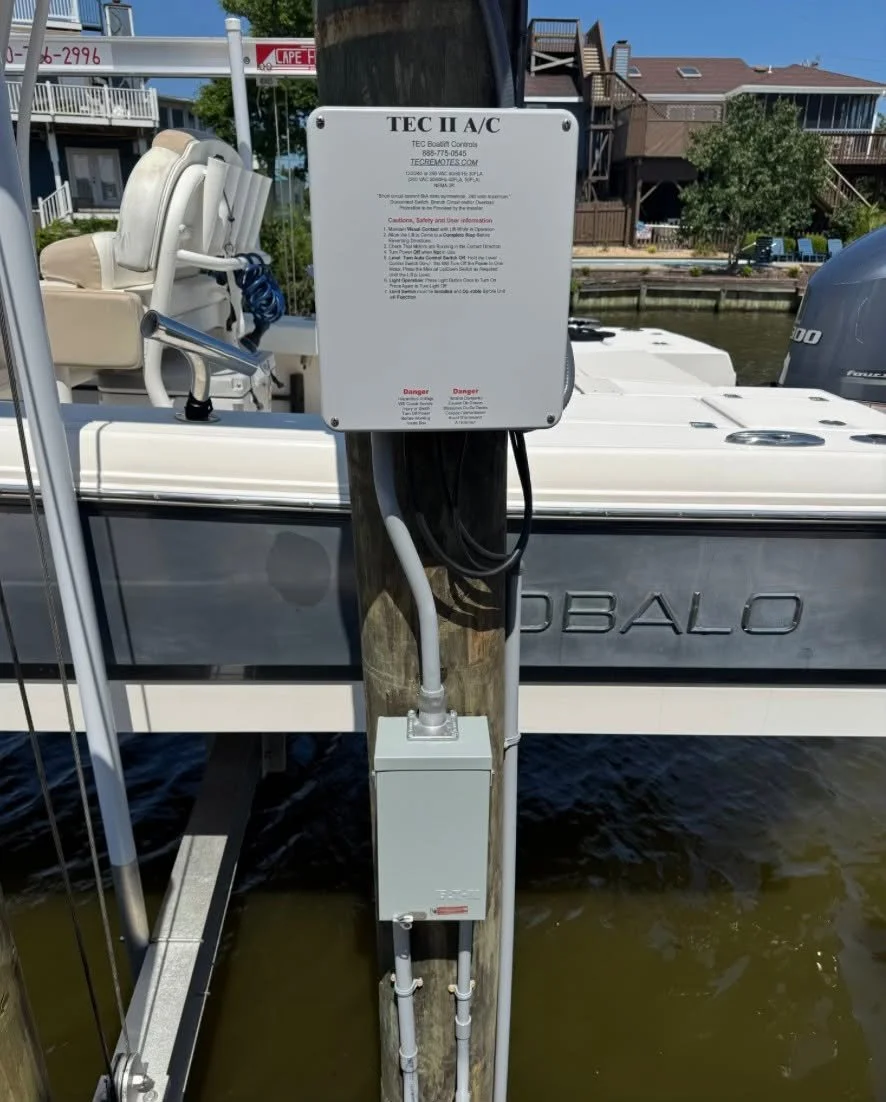

A roof keeps rain off the equipment, but it does nothing to the tide. Boxes, lift controls, and receptacles in a boathouse built over the water still go at or above the datum plane, and connections still stay at least 12 inches above the deck. A transformer feeding low-voltage lighting under the roof follows the same rules.
06 — Pier Permits
Where Electrical Fits in Norfolk’s Pier Permit Sequence
The city’s pier construction guide (last updated in 2018) explains that building a pier may require wetland, building, tree, and encroachment permits. Property owners secure wetland permit authorization before construction, through a Joint Permit Application. The guide adds that in most cases, city staff can help residents meet requirements to eliminate local wetland permit requirements.
The guide states that building permits are always required for pier construction. The applicant brings the wetland authorizations to the Development Services Center to secure the building permit, and the city’s FAQ lists a land survey, the Corps and VMRC approvals, the Wetlands Board approval, and a building permit application.
You or your dock builder carry those permits. We carry the electrical permit and inspection for the dock wiring.
